Goh & Daughter

Older HDB flats, opened up

Goh & Daughter renovates HDB flats, BTOs and condos from Ang Mo Kio. This 1979 3-room was finished in May, with every number on the sheet.

Project facts: Ang Mo Kio Avenue 10, 3-room
Flat3-room HDB resale, Ang Mo Kio Avenue 10
Built1979
Size67 m²
BudgetS$58,400 before GST
On site10 weeks, March to May 2026
HackedKitchen wall, store room, bath and WC partition
KeptTerrazzo floor, both bedrooms, every window opening
Open kitchen with grey and white cabinets beside a white dining table, where the old kitchen wall used to stand
Kitchen and dining, Ang Mo Kio Avenue 10. The counter now stands on the line of the old kitchen wall.
The floor plan, before and after
Floor plan of the Ang Mo Kio 3-room flat Before: an enclosed kitchen, a store room, and a separate bath and WC. The walls marked in red were hacked. After: the kitchen opens to the dining room with a counter on the old wall line, the store room becomes a pantry, and the bath and WC become one bathroom. Both bedrooms and the terrazzo living room floor are kept. Bedroom11.2 m² Bath2.0 WC1.7 Kitchen7.8 m² Yard Store Living and dining25.1 m² Bedroom11.9 m² hack Bedroom11.2 m² Bathroom3.7 m² Kitchen Yard Pantry Living and dining35.4 m² open Terrazzo, kept and polished Bedroom11.9 m² 1 m

Walls hackedWalls keptNew carpentry and walls

Roughly what S$55,000 buys, before GST

3-room resalebuilt in the 1970s or 80s
Hacking, full rewiring, both wet areas and a new kitchen. Little room left for carpentry.
4-room BTOnew, keys just collected
Carpentry in every room, vinyl floors, lighting and paint, with about S$8,000 to spare.
5-room resalebuilt before 1995
Hacking, rewiring and both bathrooms. The bedroom carpentry waits for a second phase.
See every price

“We bought the flat for the terrazzo. Mr Goh was the only one who said to keep it.”

Wei Ling T., owner, Ang Mo Kio Avenue 10

Recent flats

Bishan, 4-room resale, built 1988

White kitchen with open timber shelves, a steel cooker hood and square white wall tiles

The kitchen moved to the window wall, so the cook can see the void deck. Parquet kept in both bedrooms. 92 m² · S$64,000 · 11 weeks

Hougang, 3-room resale, built 1985

Narrow white galley kitchen leading to a window at the far end

Nothing hacked: the galley kitchen stayed, rebuilt with full-height cabinets. 64 m² · S$52,300 · 10 weeks

Every flat we finish gets a sheet like the one at the top of this page. It goes into the handover file with the keys.

Serangoon North, 5-room resale, built 1991

White marble-look bathroom with a glass shower screen, wall-hung toilet and a white vanity

Both bathrooms hacked down to the screed, waterproofed and water-tested for 48 hours before a single tile went down. 121 m² · S$82,500 · 12 weeks

Yio Chu Kang condo, 2 bedrooms, built 2004

Living room with a white sofa, wall-to-wall shelving and a pale blue kitchen island behind

The kitchen partition came down with the management's approval; the marble floor stayed. 78 m² · S$41,000 · 7 weeks

Ang Mo Kio, 4-room BTO, keys 2025

White bedroom with a full-height built-in wardrobe and a black wire pendant lamp

A new flat, so no hacking: three wardrobes, vinyl and lighting. HDB's kitchen and bathroom tiles kept. 93 m² · S$44,800 · 8 weeks

Prices, before GST

Starting prices. After the flat walk each one becomes an itemised quote, fixed in writing unless you change the design.

You pay in stages as work is done: 10% to start, and the last 5% only after we have fixed everything on your defects list. Workmanship is guaranteed for 12 months, bathroom waterproofing for 5 years.

Ten weeks, in order

  1. Saturday: the flat walk

    Mr Goh walks the flat with you for an hour, knocks on the walls and marks your HDB floor plan in red pen: what can go, what stays.

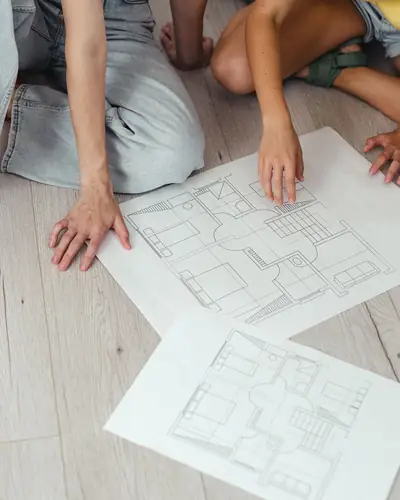

    Two people kneeling on a floor over printed floor plans
  2. Week one: the drawing

    Pei Shan draws the after plan to the centimetre and prices it line by line. The quote is fixed unless you change the design.

  3. Weeks two and three: hacking

    Once the HDB permit is in, we tell your neighbours in writing, then hack on weekdays from 9am to 5pm. Debris goes down every day.

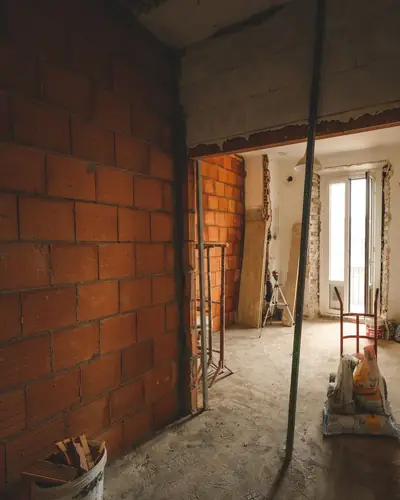

    A gutted room with bare brick walls and rubble on the floor
  4. Weeks three to five: pipes and wiring

    New pipes in the wet areas and full rewiring from a new DB box, chased into the walls, never stuck on top.

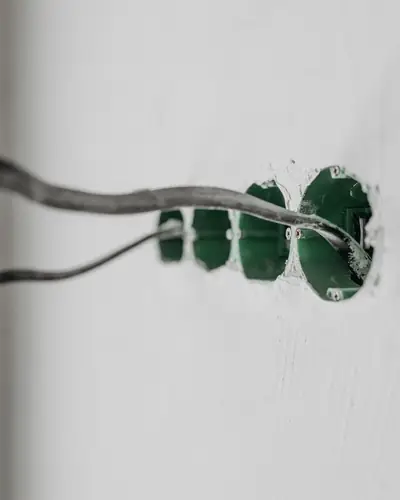

    Electrical wires coming out of a fresh socket box in a white wall
  5. Weeks five to seven: wet works

    Waterproofing, a 48-hour water test, then tiles. In a 1979 flat this is where old leaks are fixed for good.

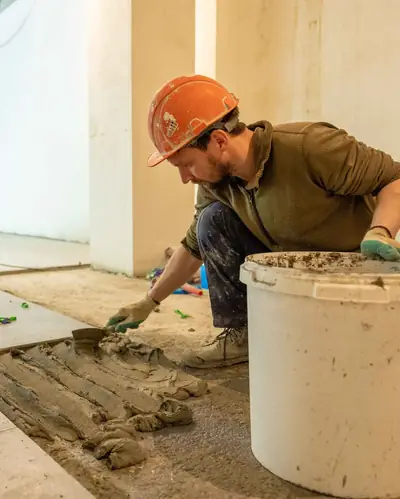

    A tiler in a hard hat setting floor tiles into fresh mortar
  6. Weeks seven to nine: carpentry

    Cabinets are built at our Ang Mo Kio workshop and fitted in two or three days. Doors, frames and trims follow.

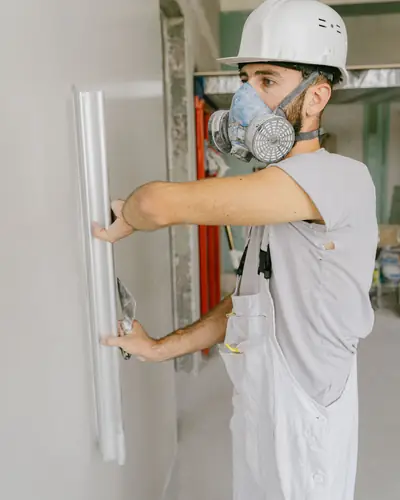

    A worker in a mask and white overalls fitting a door frame
  7. Week ten: paint, clean, keys

    Two coats of paint and a deep clean. We walk every room with you, fix the defects list, then hand back the keys.

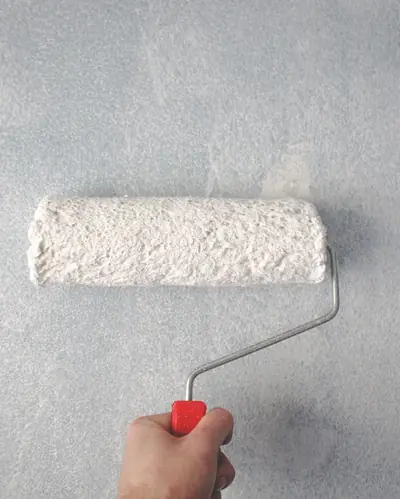

    A hand rolling white paint onto a grey wall

Since 1991, in Ang Mo Kio

Goh Kim Seng started as a tiler on HDB upgrading jobs in Ang Mo Kio and has worked inside these blocks ever since. His daughter Pei Shan trained as an interior designer and joined in 2016. He runs every site. She draws every plan.

On site
Goh Kim Seng, since 1991
On paper
Goh Pei Shan, since 2016
Carpentry
Rahman, 22 years with us
Flats at a time
Four, never more
A designer at a white table holding yellow and green colour sheets, with paint chips in front of her

We take four flats at a time, never more, so one of us is on your site every working day. Most jobs are within twenty minutes of the workshop.

Ang Mo Kio

Workshop and design room, Ang Mo Kio Industrial Park 2

Before you hack anything

How much does it cost to renovate an old 3-room HDB flat?

Most 1970s and 1980s 3-room flats we renovate cost S$50,000 to S$65,000 before GST. That covers hacking, full rewiring, both wet areas and a new kitchen. Carpentry is where budgets differ most, so we price it line by line after the flat walk, and the quote is fixed in writing.

Which walls in an HDB flat can be hacked?

Only non-structural walls, and only with an approved HDB renovation permit. Structural walls, columns and the household shelter must stay. Older flats often have more structural walls than people expect, so we check your flat's HDB floor plan and the walls themselves before we promise an open kitchen.

How long does a resale HDB renovation take?

About 10 weeks on site for a 3-room resale flat and 11 to 12 weeks for a 5-room, plus about two weeks before that for drawings and the HDB permit. A new BTO flat with no hacking usually takes 7 to 8 weeks from the day we start.

Can you keep my old terrazzo or parquet floor?

Often, yes. Terrazzo can be ground and polished, and parquet can be sanded and re-varnished, for far less than new flooring. We test a small patch during the flat walk and tell you plainly if a floor is too cracked or uneven to save.

When can noisy works like hacking happen in an HDB flat?

HDB allows noisy works such as hacking and drilling only on weekdays, between 9am and 5pm. We plan all hacking into about one week, tell your neighbours in writing beforehand, and clear debris every day so the common corridor stays clean.

Is the flat walk free?

Yes. The flat walk takes about an hour, on a Saturday morning or a weekday evening, and costs nothing. Bring your HDB floor plan if you have one. If you decide to go ahead, the measured drawing and itemised quote follow within a week.

Bought an older flat, or about to collect a new one? Tell us the block and the year it was built.

White footbridge over the pond in Bishan–Ang Mo Kio Park

Rather talk first?

Ang Mo Kio Industrial Park 2. We reply within one working day.

Book a flat walk

Free, about an hour, in your flat. Saturday mornings or weekday evenings.

  • Bring your HDB floor plan if you have one.
  • Resale buyers: we can walk the flat before you complete.
  • You get the drawing and quote within a week.
